Jaquez Anders
Austin Beam
Jeff Beard
Abraham Bejil
Nate Brignon
Adrian Carrasco
Ashley Colquitt
Eileen Corley
Amanda Day

Aaron Erdwurm
Christine Foreman
Matthew Galindo
Beth Garza
Kenneth Green
Whitney Groves
Josh Ham

Jack Harper
Stephanie Mead

John Schlaffer
Ronnie Scott
Sam Sledge
Emily Smith
Jarrod Sparks
Stan VanHoozer
Danny Wesson
Toby Widman
Katrena Williams

Advisory Committee Meeting Updates

November 19, 2025

The Midland ISD Bond Advisory Committee met for the ninth time to hear an update on the progress of the 2023 Midland ISD School Bond. The committee was reminded of their roles and responsibilities and heard reports on construction and project timelines and costs related to bond projects.

OPERATIONS

PACKAGE 01 – LONE STAR TRAILS ELEMENTARY

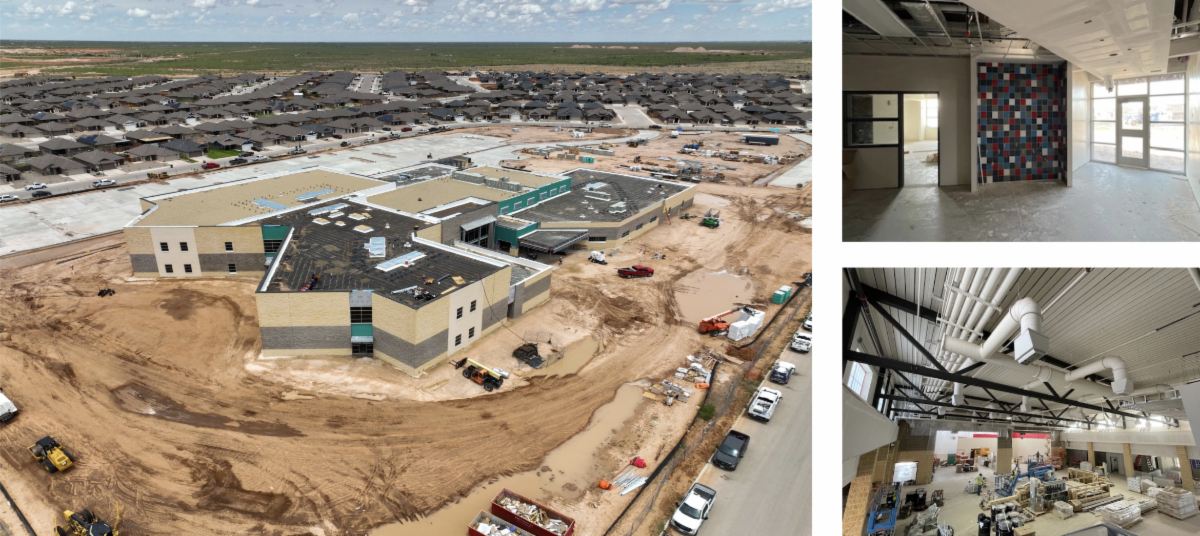

Lone Star Trails is nearing final completion as contractors wrap up remaining details. Door hardware has been received, and lock cores throughout the administration offices—including the final two between the reception area and hallway—were replaced last week. The Terrazzo floor, in the cafeteria/ commons, has also received its final polish.

Additional interior updates include new tile along the front of the cafeteria serving line and installation of VCT flooring in the cafeteria office. All remaining work is taking place after hours and on weekends to avoid disrupting campus operations. Weekly coordination meetings with school administrators, maintenance staff, and Parkhill continue to address punch list items. Of the 659 items logged, roughly 92% are now complete.

Concrete sidewalk replacement along the northwest corner of the school is scheduled for the Thanksgiving break to minimize impact on students and staff.

The project remains in its one-year warranty period, with punch list resolution ongoing.

Final Project Costs

  • Bond Budget: $53,300,000
  • Projected Final Cost: $42,968,894
  • Projected Savings: $10,331,106

PACKAGE 02 – NEW HIGH SCHOOLS

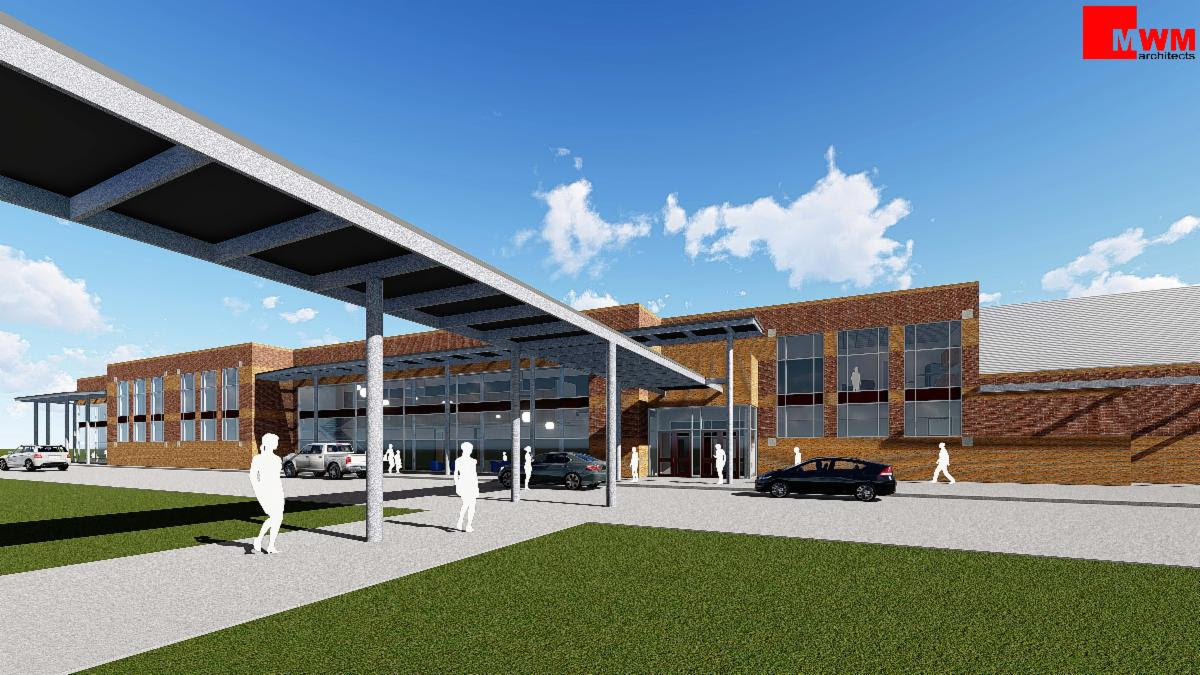

New Midland Lee High School

The project remains slightly ahead of schedule with steady progress across the expansive site. Crews continue grading, earthwork, and concrete footing pours, supported by ongoing dust mitigation.

As crews advance deeper into the site, they will encounter more rock, slowing production and aligning progress more closely with Midland High School’s schedule. The next major milestone—vertical construction—is anticipated to begin in spring/summer 2026. Steel top-out is projected for fall 2026, with permanent power and HVAC systems coming online in early 2027.

Off-Site Infrastructure (Avalon & Thomason Utilities – PKG 2A)

  • Approved at the October Board Meeting
  • $401,213.73 below MISD budget
  • $140,685.86 below City of Midland budget

New Midland High School

The project is on schedule, with site activity increasing as conditions allow work to progress more efficiently than at Midland Lee. Crews continue earthwork, including soil lifting, boring, and pond excavation. Foundation and site preparations are advancing well.

Coordination with Oncor remains ongoing to remove outdated electrical systems and install permanent power infrastructure. Midland High School is on track to align with Midland Lee in beginning vertical construction next year.

Pipeline easement discussions are also underway.

GMP Summary

  • Total GMP #1: $545,763,904
  • Total GMP #2: $120,022,125
  • Total GMP #3: $169,122,441
  • Total Final GMP (PKG 02): $834,908,470
  • Total Construction Budget: $841,400,000
  • Total Savings: $6,491,530

PACKAGE 03 – ELEMENTARY SCHOOL RENOVATION – GROUP A

Bond work across Emerson, Franks, Houston, Lamar, Long, Parker, South, and IDEA Travis Elementary Schools continues to progress. GMP #1 is complete, with final work at Emerson Elementary scheduled to wrap up in December as fire sprinklers are installed in the gym during the Christmas break. GMP #2 is slated for Board approval in January 2026. Preparations are underway for new security vestibule additions at Franks, Houston, and Lamar, which will begin early next year, while exterior maintenance and restroom renovations are planned across all campuses for summer 2026.

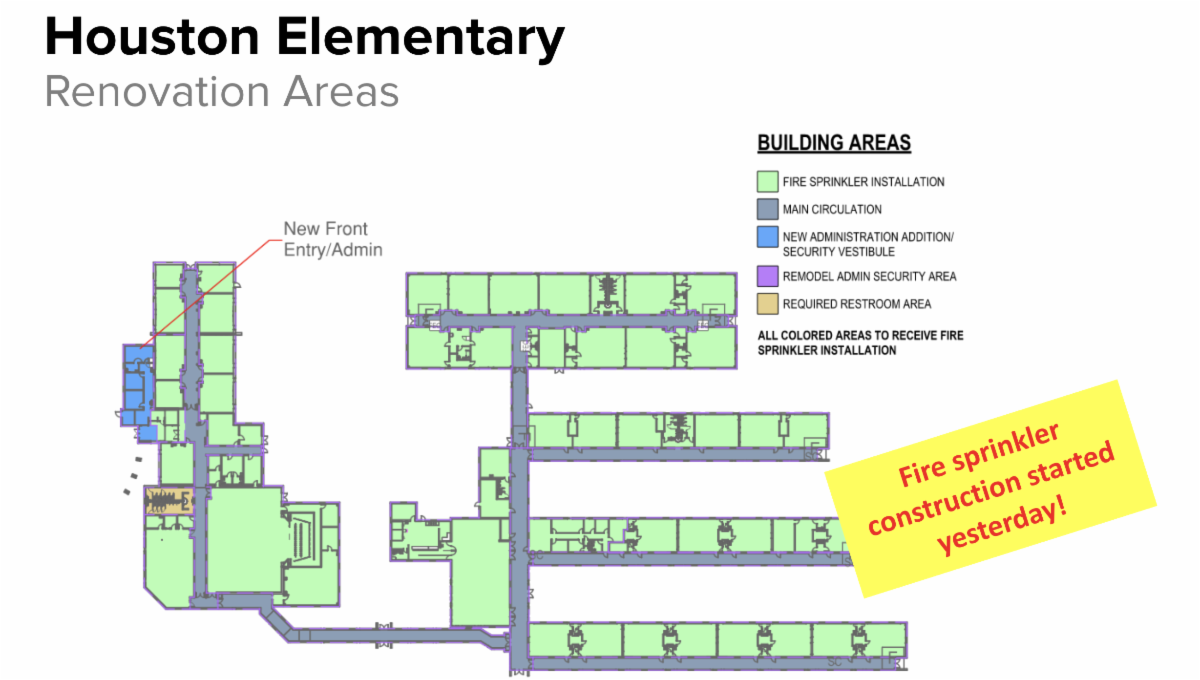

At Emerson, the upcoming fire sprinkler installation marks the final GMP #1 task, with restroom renovations and exterior maintenance planned for next summer.

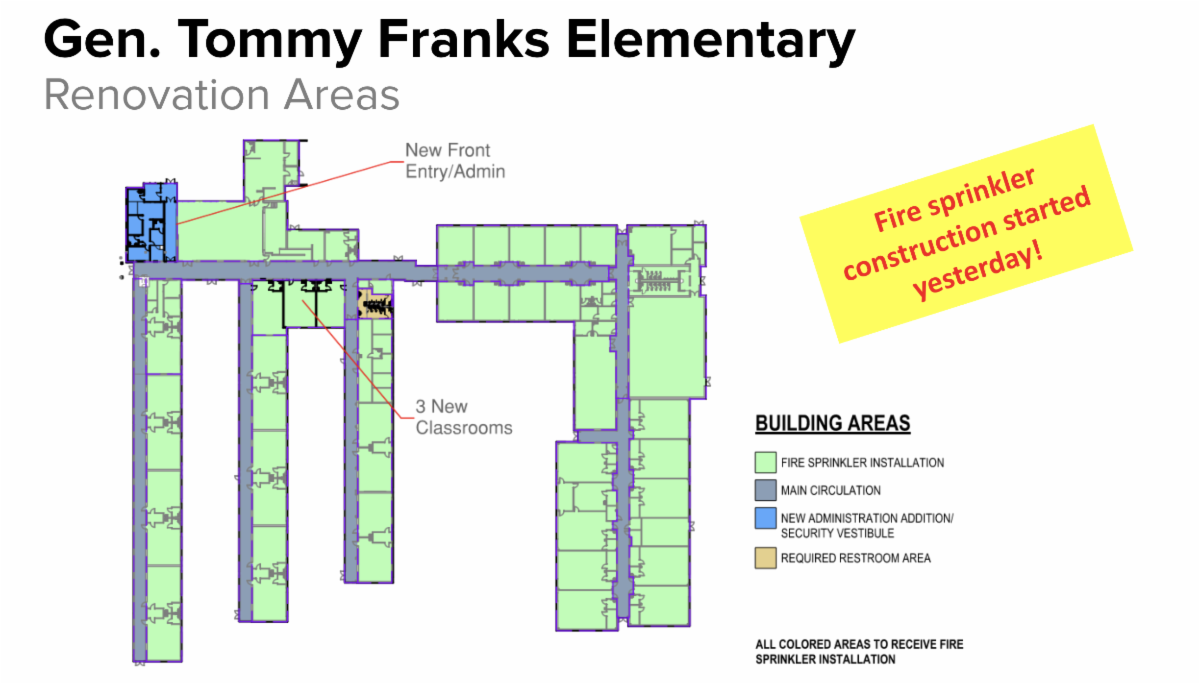

Franks and Houston each continue preparing for their vestibule additions and summer renovation work, while IDEA Travis is moving forward with HVAC improvements in the IT room ahead of additional maintenance and restroom upgrades next summer.

Parker is planning fire sprinkler work in the gym over Christmas Break, along with summer restroom and exterior updates.

Sam Houston Collegiate Preparatory and Lamar are also preparing for their vestibule additions early next year, followed by restroom renovations, fire sprinkler installation (Lamar), and exterior maintenance in the summer.

South and Jane Long Elementary Schools will complete bathroom remodeling, entry accessibility upgrades, fire sprinkler installation (Long), and exterior maintenance during the summer 2026 construction window.

PACKAGE 04 – MIDDLE SCHOOL RENOVATION – GROUP A

Construction at Goddard Middle School and Midland Freshman High School is moving forward as the construction contracts are currently under review by MISD. Contractor mobilization is expected to begin next week, with initial work focusing on the construction of new classrooms and a new administration area, which will require temporary entry locations. Future phases will include kitchen renovations and updates to existing classrooms. At both campuses, construction fencing and site preparation will soon be visible, and over the coming months, additions and expanded parking areas will take shape. The projects are on track for anticipated completion in December 2027.

PACKAGE 05 – MIDDLE SCHOOL RENOVATION – GROUP B

The design process is 100% complete. Construction at Alamo and Abell Junior High Schools is progressing on multiple fronts. The Multi-Purpose Building (MPB) is currently underway at both campuses, with grading and excavation in full swing north of the locker rooms at Alamo, and excavation soon to begin at Abell. Concrete foundations will be placed next, followed by steel framing, with both MPB projects targeting completion in early 2026. At Alamo Junior High, the contractor selection recommendation is scheduled for Board approval, with the first phase beginning in December 2025. This phase includes a new classroom addition and new library addition, while future phases will address kitchen renovations and updates to existing classrooms. The full Alamo project is anticipated to be completed by spring 2028.

PACKAGE 08 – ELEMENTARY SCHOOL RENOVATIONS – GROUP B

The design process is currently 50% complete. At Santa Rita Elementary, the drop-off drive, design development phase, and construction documents are 100% complete. Construction bids are planned for spring 2026, with work anticipated to begin in summer 2026. The project is expected to reach completion in fall 2028.

PACKAGE 09 – MIDDLE SCHOOL RENOVATIONS – GROUP C

The design phase for San Jacinto and Abell Middle Schools is currently 28% complete. Flooring upgrades were completed in summer 2025, and the schematic design phase is 100% complete. Construction documents are scheduled to be completed by summer 2026, with construction bids planned for late summer 2026 and work anticipated to begin in fall 2026. The project is expected to reach completion in fall 2028.

PACKAGE 10 – ELEMENTARY SCHOOL RENOVATIONS – GROUP C

The design phase is currently 28% complete. Construction documents are scheduled for completion by January 2026, with construction bids planned for spring 2026. Work is anticipated to begin in summer 2026, and the projects are expected to reach completion in fall 2028.

PACKAGE 11 – ELEMENTARY SCHOOL RENOVATIONS – GROUP D

The design phase is currently 11% complete. Construction documents are scheduled for completion by spring 2026, with construction bids planned for late spring 2026. Work is anticipated to begin in summer 2026, and the projects are expected to reach completion in December 2028.

NEXT MEETING

The next quarterly meeting of the Bond Advisory Committee will take place February 25, 2026.

All students will graduate ready for college, career, or military.

Midland ISD | 615 W. Missouri Avenue | Midland, TX 79701 US

August 27, 2025

The Midland ISD Bond Advisory Committee met for the eighth time to hear an update on the progress of the 2023 Midland ISD School Bond.

The committee was reminded of their roles and responsibilities and heard reports on enrollment trends and the beginning of the school year, construction and project timelines, and costs related to bond projects.

PACKAGE 01 – LONE STAR TRAILS ELEMENTARY

The district held the ribbon cutting ceremony for Lone Star Trails Elementary School on August 14, and students started school in the new building on August 19. The campus was completed on time and under budget. Final punch list items are being completed.

PACKAGE 02 – NEW HIGH SCHOOLS

The Final GMP is expected in approximately 60 days. GMP #1 was approved in June. Early work including but not limited to: earthwork, footings, underground utilities, and steel pre-orders has begun. The Development Agreement was approved by the Board of Trustees and the City of Midland on August 26. This agreement will address road, water, and sewer line needs.

PACKAGE 03 – ELEMENTARY SCHOOL RENOVATION – GROUP A

Fire suppression work (including fire sprinklers and new ceiling tiles) has been completed at six of the eight campuses. The remaining two campuses will be finished next summer.

PACKAGE 04 – MIDDLE SCHOOL RENOVATION – GROUP A

The Board of Trustees approved the CSP for this package on August 26 during the regularly scheduled board meeting. The package came in at approximately $2.5 million under budget. The estimated completion time for Package 04 is December 2027.

PACKAGE 05 – MIDDLE SCHOOL RENOVATION – GROUP B

Design progress is approximately 75% complete. Construction of the Multipurpose Facility Package, along with work at Abell, has already begun. Remainder of project is set to advertise for the CSP in September and enter into a construction contract at the end of October.

PACKAGE 08 – ELEMENTARY SCHOOL RENOVATIONS – GROUP B

The design progress is currently estimated at 35%, with the Competitive Sealed Proposal (CSP) process still to be determined. Driveway construction at Santa Rita has been completed. The Design Development phase is approximately 95% complete. The total project completion is scheduled for fall 2028.

PACKAGE 09 – MIDDLE SCHOOL RENOVATIONS – GROUP C

The Competitive Sealed Proposal (CSP) process is still under development. Schematic design is approximately 95%.

PACKAGE 10 – ELEMENTARY SCHOOL RENOVATIONS – GROUP C

Work related to this package is in the planning phase. This package will impact Bonham, Burnet, Fannin, and Henderson Elementary Schools. Additionally, this package will include MAP and Coleman HS. Project completion is anticipated in the fall of 2028.

PACKAGE 11 – ELEMENTARY SCHOOL RENOVATIONS – GROUP D

Similar to Package 10, work related to this package is also in the planning phase. This package will impact Pease, Rusk, Bowie, Greathouse, Jones, and Ben Milam Elementary Schools. Project completion is anticipated in the fall of 2028.

NEXT MEETING

The next quarterly meeting of the Bond Advisory Committee will take place November 19, 2025.

All students will graduate ready for college, career, or military.

Midland ISD | 615 W. Missouri Avenue | Midland, TX 79701 US

May 28, 2025

The Midland ISD Bond Advisory Committee met for the seventh time for an update on the progress of the 2023 Midland ISD School Bond.

The committee was reminded of their roles and responsibilities and heard reports on construction and project timelines, cost related to projects, and community engagement efforts.

COMMUNITY ENGAGEMENT

Midland ISD remains committed to keeping the 2023 School Bond at the forefront of community awareness through regular distribution of press releases, media advisories, updates in parent and staff newsletters, and consistent social media engagement.

Since the last Bond Advisory Committee meeting, the district has hosted several presentations showcasing the selected finishing materials for the new Legacy and Midland High School campuses.

Additionally, the district announced the names and mascots of the two new middle schools being constructed under the 2023 Bond Program: John “Randy” Storie Middle School and Midland Middle School. These names reflect extensive community input and celebrate Midland’s rich educational heritage.

Updates to midlandbond2023.com have also been made and include renderings of projects for elementary and middle schools for safety and security, classroom additions, and the new high schools. The Bond Projects page on the website includes timestamped details about each bond project.

OPERATIONS

PACKAGE 01 – LONE STAR TRAILS ELEMENTARY

Renderings of Lone Star Trails Elementary were presented to the committee along with construction photos.

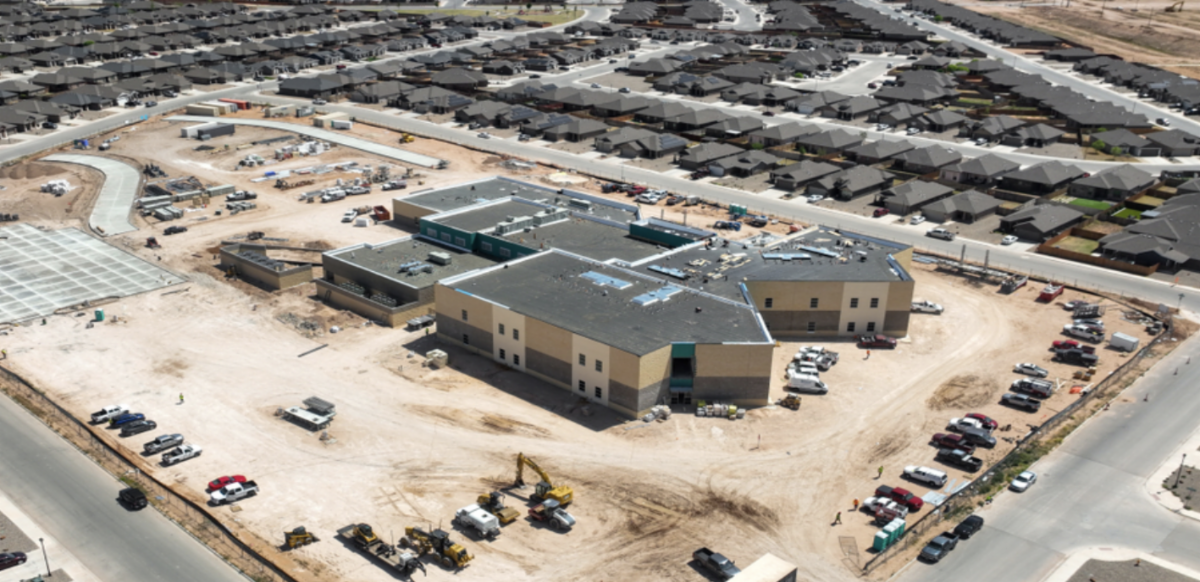

The construction of Lone Star Trails Elementary is 75% complete and remains on track to open in August 2025. Significant progress has been made, with metal stud installation complete, roofing complete, and the drywall at 75% complete. All A/C units have been delivered and are 40% complete. Furniture is expected to be delivered on June 30. Additionally, the building plaque names have been verified and ordered, and staffing efforts are fully underway.

The district is on track to open on time in August 2025.

PACKAGE 02 – NEW HIGH SCHOOLS

Design development has been completed, and the Construction Documentation phase is currently underway. This phase began with 13 meetings involving various community leaders, MISD leadership, staff, and students. Construction Documentation is approximately 60% complete and is on track for finalization by September 2025.

The plans for the Athletic and Performing Arts facilities and equipment layouts have been finalized and approved. Subcontractor bids were received on May 9, and preparations are underway to present GMP#1 for Board approval in June to initiate early construction work.

The groundbreaking ceremony for Legacy High School will be held at 8:30 a.m. on June 25, and the groundbreaking for Midland High School will take place June 26 at 8:30 a.m.

PACKAGE 03 – ELEMENTARY SCHOOL RENOVATION – GROUP A

Construction is scheduled to begin in Summer 2025. This summer, fire sprinklers and new ceilings will be installed in six of the eight buildings, with Long and Lamar excluded due to summer school activities. The Construction Manager at Risk (CMAR) has recommended an early release of fire protection work to allow installation of primary piping during this timeframe. Furniture and personal items were moved into the gym and cafeteria yesterday, and demolition has officially begun. The remaining work package is expected to be finalized by mid-summer in preparation for a fall 2025 start.

PACKAGE 04 – MIDDLE SCHOOL RENOVATION – GROUP A

The design is 100% complete, with construction documents finalized. Bids for the Competitive Sealed Proposal (CSP) will be received at the end of June, and a contract award is scheduled for approval at the July board meeting. Asbestos abatement will begin on June 1, with construction of the new classroom addition set to start in summer 2025.

PACKAGE 05 – MIDDLE SCHOOL RENOVATION – GROUP B

Design progress is approximately 75% complete. Construction of the Weight Room Package, along with work at Abell, is set to begin immediately. Budget approval for the 50% construction documents was secured in mid-May. Portable classrooms are scheduled for relocation in June 2025, with construction of the new classroom addition planned to begin in fall 2025.

PACKAGE 06 – SAFETY & SECURITY

Completed.

PACKAGE 07 – MIDLAND FRESHMAN SITE IMPROVEMENTS

Completed.

PACKAGE 08 – ELEMENTARY SCHOOL RENOVATIONS – GROUP B

The design progress is currently estimated at 10%, with the Competitive Sealed Proposal (CSP) process still to be determined. Driveway construction at Santa Rita began early and is approximately 50% complete. Consultations with Vermeulen’s are ongoing for cost estimations, and initial site visits to all four schools have been completed, with more detailed assessments scheduled for early June. The Design Development phase is approximately 50% complete.

PACKAGE 09 – MIDDLE SCHOOL RENOVATIONS – GROUP C

The Competitive Sealed Proposal (CSP) process is still under development. Construction of the Abell Junior High weight room is scheduled for this summer, while data gathering and scope validation efforts are currently underway.

NEXT MEETING

The next quarterly meeting of the Bond Advisory Committee will take place August 27, 2025.

February 26, 2024

The Midland ISD Bond Advisory Committee met for the sixth time for an update on the progress of the 2023 Midland ISD School Bond.

The committee was reminded of their roles and responsibilities and heard reports on construction and project timelines; cost of projects and community engagement efforts.

COMMUNITY ENGAGEMENT

The district aims to keep the Midland ISD 2023 School Bond top of mind through continually distributing press releases, media advisories, including information in parent and staff newsletters, and social media posts.

Since the last meeting of the Bond Advisory Committee, the district hosted a beam signing ceremony for the new Lone Star Trails Elementary School.

Updates to midlandbond2023.com have also been made and include renderings of projects for elementary and middle schools for safety and security, classroom additions, and the new high schools. The Bond Projects page on the website includes timestamped details about each bond project.

OPERATIONS

PACKAGE 01 – LONE STAR TRAILS ELEMENTARY

Renderings of Lone Star Trails Elementary were presented to the committee along with construction photos.

The temporary power was connected in early January, and the permanent power is scheduled for April 2025. All of the steel erection and building floor slabs are complete, and the two-story portion is roofed and dried in. The cold weather setbacks are being recovered.

The district is pleased to report that Lone Star Trails Elementary School project is $8.5 million under budget and is on track to open on-time in August 2025.

PACKAGE 02 – NEW HIGH SCHOOLS

Sixty-four user group meetings have been held since August 2024 focusing on design. The construction document phase is 30% complete. In addition, thirty-two design development review meetings have taken place.

The abatement and demolition at the site of the new Midland High School are complete, and 276 large trees have been salvaged for replanting. These trees will be replanted at both of the new high school locations.

PACKAGE 03 – ELEMENTARY SCHOOL RENOVATION – GROUP A

The scope of work in this package includes adding security vestibules and security improvements, new fire sprinkler systems, accessibility and code updates, and renovations to aging facilities. Elementary schools included in Package 03 include Emerson, Franks, Sam Houston, Lamar, Long, Parker, South, and Travis

Floor plans of the renovations were presented, and construction is expected to begin in the fall of 2025. Fire suppression is approximately 60% complete and renovations are 30% complete.

PACKAGE 04 – MIDDLE SCHOOL RENOVATION – GROUP A

The current Midland Freshman High School, which will become a middle school, and Goddard Junior High School make up Package 04. The scope of work in this package includes a new entrance with a security vestibule, new classrooms, new administration office, kitchen and dining upgrades, a new sprinkler system, ADA upgrades, and Life Safety upgrades. The package also contains renovations to aging facilities.

Construction is slated to begin in the summer of 2025, and the construction document phase is approximately 80% complete. Design plans and aerial renderings of the two campuses are pictured below. *Midland Middle School is a placeholder name for the current Midland Freshman High School that will be converted into a middle school.

PACKAGE 05 – MIDDLE SCHOOL RENOVATION – GROUP B

Alamo Junior High School will receive new classrooms, a new library, secured vestibules, new weight room annex, kitchen and dining upgrades, a new sprinkler system, ADA upgrades, Life Safety upgrades, and renovations to aging facilities.

Construction is expected to begin in the summer of 2025, and the design development is approximately 100% complete.

PACKAGE 06 – SAFETY & SECURITY

Twenty-four elementary schools and two secondary campuses are included in this package. Updates include access controls, security cameras, and emergency communications. In addition to secured vestibules at the current Midland High School and Legacy Freshman High School.

Construction on this package began in the summer of 2024 and is approximately 97% complete.

PACKAGE 07 – MIDLAND FRESHMAN SITE IMPROVEMENTS

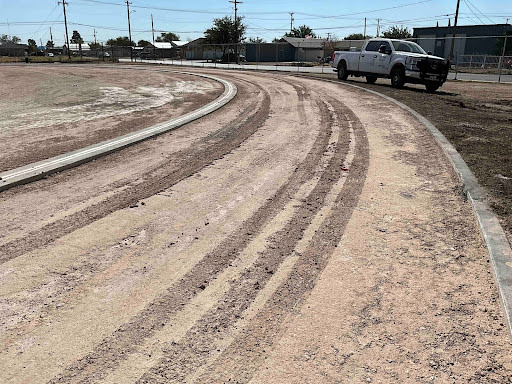

The campus received a new four-lane track with field event areas, a outdoor field scoreboard, field bleachers with ADA seating, site lighting, and tennis courts, windscreens, and backboards.

The site work at the current Midland Freshman campus is complete.

PACKAGE 08 – ELEMENTARY SCHOOL RENOVATIONS – GROUP B

Package 08 consists of Bush, Scharbauer, De Zavala, and Santa Rita elementary schools and includes security improvements, accessibility and code upgrades, and renovations to aging facilities. The design development was approved and the construction development package is 50% complete. Interior finishes are being finalized and a plan for Asbestos Abatement has been coordinated.

A new pickup/drop-off driveway circling the campus will be implemented to improve student arrival and dismissal. Materials will be arriving next week and set to be completed before the end of the school year.

Construction on this package began in the fall of 2025. The scope to budget and schematic design is approximately 10% complete.

PACKAGE 09 – MIDDLE SCHOOL RENOVATIONS – GROUP C

Abell and San Jacinto junior highs make up Package 09. Improvements at these campuses include new classrooms, secured vestibules, kitchen/dining upgrades and expansions, new sprinkler systems, ADA upgrades, Life Safety upgrades, and renovations to aging facilities and site improvements. Campus focus groups have been conducted with the architects.

NEXT MEETING

The next quarterly meeting of the Bond Advisory Committee will take place May 28, 2025.

All students will graduate ready for college, career, or military.

November 20, 2024

The Midland ISD Bond Advisory Committee met for the fifth time to hear a report on the status of the 2023 Midland ISD School Bond.

The committee was reminded of their roles and responsibilities and heard reports on construction and project timelines; cost of projects and community engagement efforts.

COMMUNITY ENGAGEMENT

The district aims to keep the Midland ISD 2023 school bond top of mind through continually distributing press releases, media advisories, including information in parent and staff newsletters, and social media posts.

Since the last meeting of the Bond Advisory Committee, the district hosted Pfluger Architects and their Test. Immerse. Navigate. Analyze (otherwise known as TINA) virtual experience the week of October 28. Multiple events were held throughout the week for students, parents, community members, community partners, and board members to view the renderings of the new high schools in an immersive, virtual experience.

Updates to midlandbond2023.com have also been made and include renderings of projects for elementary and middle schools for safety and security, classroom additions, and the new high schools.

The campus website for Lone Star Trails Elementary is now live, and the campus has active Facebook and Twitter pages.

OPERATIONS

PACKAGE 01 – LONE STAR TRAILS ELEMENTARY

Renderings of Lone Star Trails Elementary were presented to the committee along with construction photos.

The project is in the construction stage and is on track to open in August 2025.

PACKAGE 02 – NEW HIGH SCHOOLS

Forty-nine user group meetings have been held since August focusing on design. The design development is set to be completed at the end of this year. User groups provide valuable feedback from teachers, students, departments, community members, and district leadership.

Currently, abatement and demolition is underway at the site of the new Midland High School.

Renderings of the new campuses were shown along with a video.

PACKAGE 03 – ELEMENTARY SCHOOL RENOVATION – GROUP A

Elementary schools included in Package 03 include Emerson, Franks, Sam Houston, Lamar, Long, Parker, South, and Travis. The scope of work included in this package includes adding security vestibules and security improvements, new fire sprinkler systems, accessibility and code updates, and renovations to aging facilities.

Floor plans of the renovations were presented, and construction is expected to begin in the summer of 2025. The schematic design is approximately 20% complete.

PACKAGE 04 – MIDDLE SCHOOL RENOVATION – GROUP A

The current Midland Freshman High School and Goddard Junior High School make up Package 04. The scope of work included in this package includes a new entrance with a security vestibule, new classrooms, new administration, kitchen and dining upgrades, a new sprinkler system, ADA upgrades, and Life Safety upgrades. The package also contains renovations to aging facilities.

Construction is slated to begin in the spring/summer of 2025, and the design development is approximately 40% complete. Aerial renderings of the two campuses are pictured below.

Aerial view of middle school #5 (currently Midland Freshman High School)

Aerial view of the renovated Goddard Middle School

PACKAGE 05 – MIDDLE SCHOOL RENOVATION – GROUP B

Alamo Junior High School will receive new classrooms, a new library, secured vestibules, kitchen and dining upgrades, a new sprinkler system, ADA upgrades, Life Safety upgrades, and renovations to aging facilities. Construction is expected to begin in the summer of 2025, and the design development is approximately 30% complete.

PACKAGE 06 – SAFETY & SECURITY

Twenty-four elementary schools and two secondary campuses are included in this package. Updates include access controls, security cameras, and emergency communications, in addition to secured vestibules at the current Midland High School and Legacy Freshman High School. Construction on this package began in the summer of 2024 and is approximately 50% complete.

PACKAGE 07 – MIDLAND FRESHMAN SITE IMPROVEMENTS

The sitework at the current Midland Freshman campus is nearing the end of construction with 80-90% of the work complete.

PACKAGE 08 – ELEMENTARY SCHOOL RENOVATIONS – GROUP B

Package 08 consists of Bush, Scharbauer, De Zavala, and Santa Rita elementary schools and includes security improvements, accessibility and code upgrades, and renovations to aging facilities.

PACKAGE 09 – MIDDLE SCHOOL RENOVATIONS – GROUP C

Abell and San Jacinto junior highs make up Package 09. Improvements at these campuses include new classrooms, secured vestibules, kitchen/dining upgrades and expansions, new sprinkler systems, ADA upgrades, Life Safety upgrades, and renovations to aging facilities and site improvements.

NEXT MEETING

The next quarterly meeting of the Bond Advisory Committee will take place in February of next year.

The Bond Advisory Committee met for the fourth time to hear a report on the status of the 2023 MISD School Bond.

The committee was reminded of its roles and responsibilities and heard reports on construction and project timelines; finance reports; and communication and community engagement efforts.

COMMUNITY ENGAGEMENT

Campus project signs have been installed in front of the campuses. Each sign informs the public of the specific projects unique to the specific campus along with a QR code directing the public to the 2023 bond website for more information.

Updates have been made to MidlandBond2023.com, including a revamped Finance page that includes all press releases related to finance, bond sales and anticipated bond sales. Videos have been added to the Bond Advisory webpage along with a section dedicated to meeting recaps.

Since the committee last met, the groundbreaking of the new elementary school has taken place, and a community survey was distributed asking for nominations for the name and mascot of the new school. Per district policy, a committee was formed and will seek approval from the MISD Board of Trustees in September.

OPERATIONS

Project progress on the new elementary school, new high schools, elementary school safety and security updates, middle school updates, and the site improvements taking place at Midland Freshman High School were presented.

The new elementary school is on schedule to open in the fall of 2025. Site work is complete, sub-slab utilities are in, and the grade foundations and slab will be poured soon.

Work on the two new high schools is well underway. The Construction Managers at Risk (CMARs) have been selected and design meetings with district user groups have taken place. Schematic design is scheduled to be complete next month and twelve meetings have taken place with the CMARs on scope and cost review. The projects are on schedule, and the anticipated opening remains the fall of 2028.

Cabling for the elementary school safety and security package has been pulled in 14 of 26 schools, with South Elementary in progress. Schematic design was discussed and included an overview of the new secure vestibules that will be added to these campuses. The bids for these projects will be issued by the end of this year, with an anticipated completion of the fall of 2026.

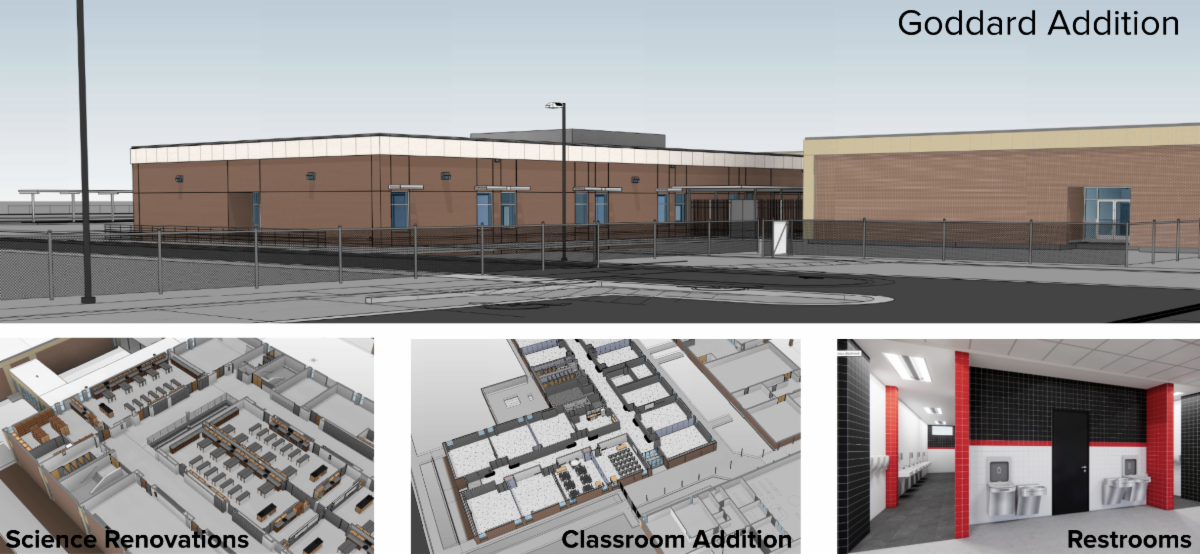

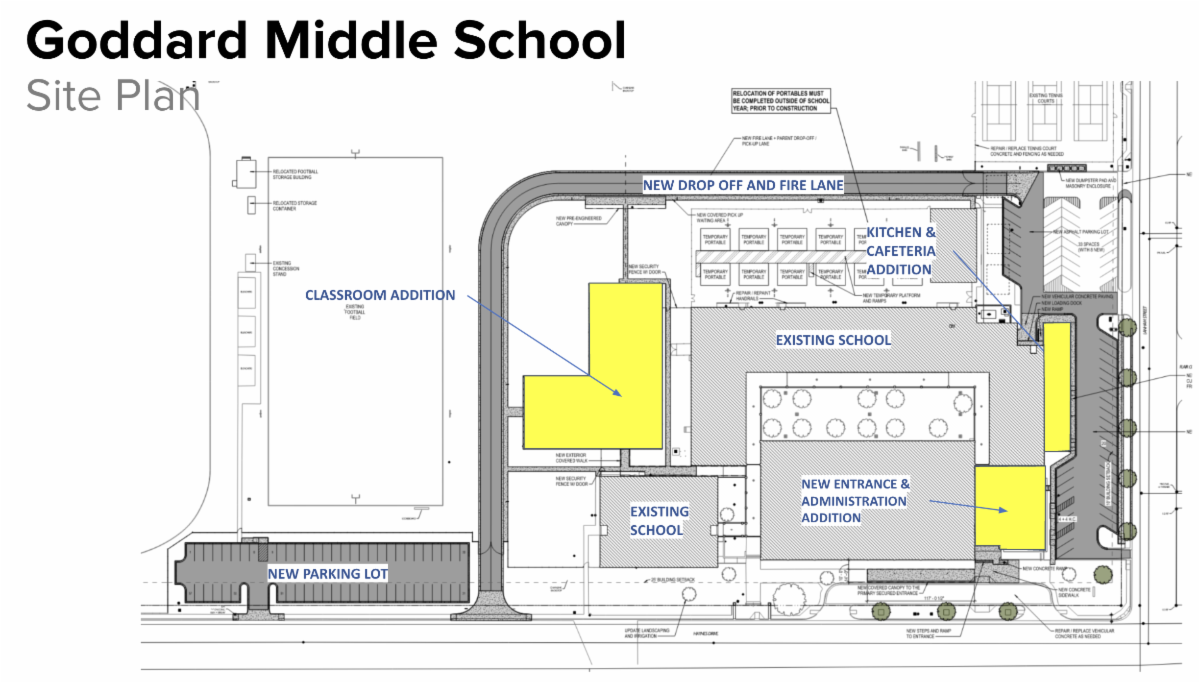

The first package of middle school work at Goddard Junior High and the current Midland Freshman High School is in the schematic design phase. As previously communicated, these projects were chosen as the first middle school projects to take place as they have the same floor plan. Updates to these campuses include kitchen additions, secured vestibules and classroom additions.

The second middle school package is taking place at Alamo Junior High. Classroom additions and a new library were presented. The two-story classroom addition is expected to be completed in the fall of 2026.

The elementary school safety and security package, which consists of 26 elementary schools, was presented. These projects include security cameras, cabling, and updated/additional access controls. They are scheduled to be completed in March 2025.

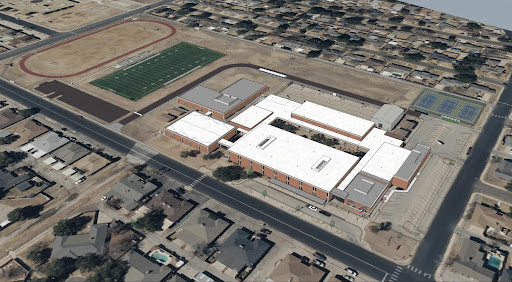

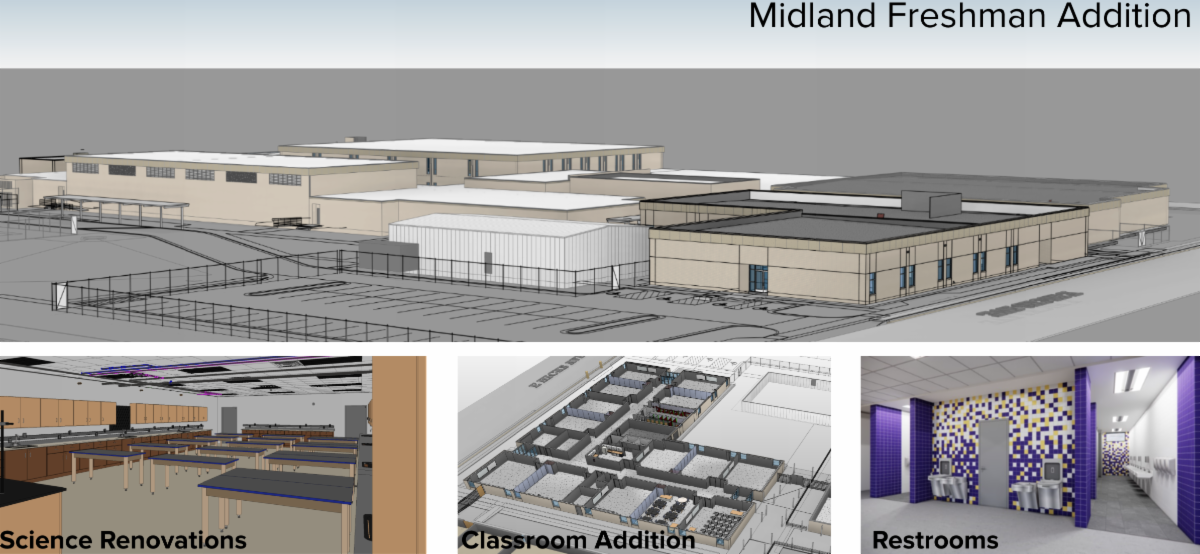

Site improvements are also well underway at Midland Freshman High School. The tennis court slab has been poured, track curbs are complete, and the base material is in the final grading stages. This work is scheduled to be completed by the end of this year.

At its regular August meeting, the Board of Trustees approved the architecture and engineering firm for Package Eight, which includes four elementary schools – Bush, Scharbauer, DeZavala, and Santa Rita. These campuses were chosen based on the large amount of work needed at these campuses.

FINANCE

As presented to voters prior to the passage of the bond, the overall tax rate for the 2024-25 fiscal year has remained flat at $0.877. The recent defeasance that took place in August was also presented. The defeasance saved taxpayers over $35 million, and the district anticipates future defeasences to save even more.

      Interest Rate

  • Planned Interest Rate: 5.25% – 5.50%
  • Actual Interest Rate: 4.09%
  • Estimated Savings: $310 Million

       Savings

  • Total savings since 2012: $56,240,128
  • Recent defeasance saved taxpayers $35,812,950
  • Total savings to taxpayers from refinancing and defeasing existing debt since 2012 of $92,053,078
  • Outstanding principal amount of $15,930,000 remaining, reduced from $125,056,986

The Bond Advisory Committee met for the third time to hear a report on the status of the 2023 MISD School Bond.

The committee was reminded of their roles and responsibilities and heard reports on construction and project timelines; cost of projects and finance reports; and communication and marketing efforts.

OPERATIONS

Procurement procedures were presented about processes school districts must follow related to the procurement of professional services and construction processes.

Updates were given on the bond packages, and the district reported that of the 1.4 billion bond, $1.1 billion has already been assigned to bond projects.

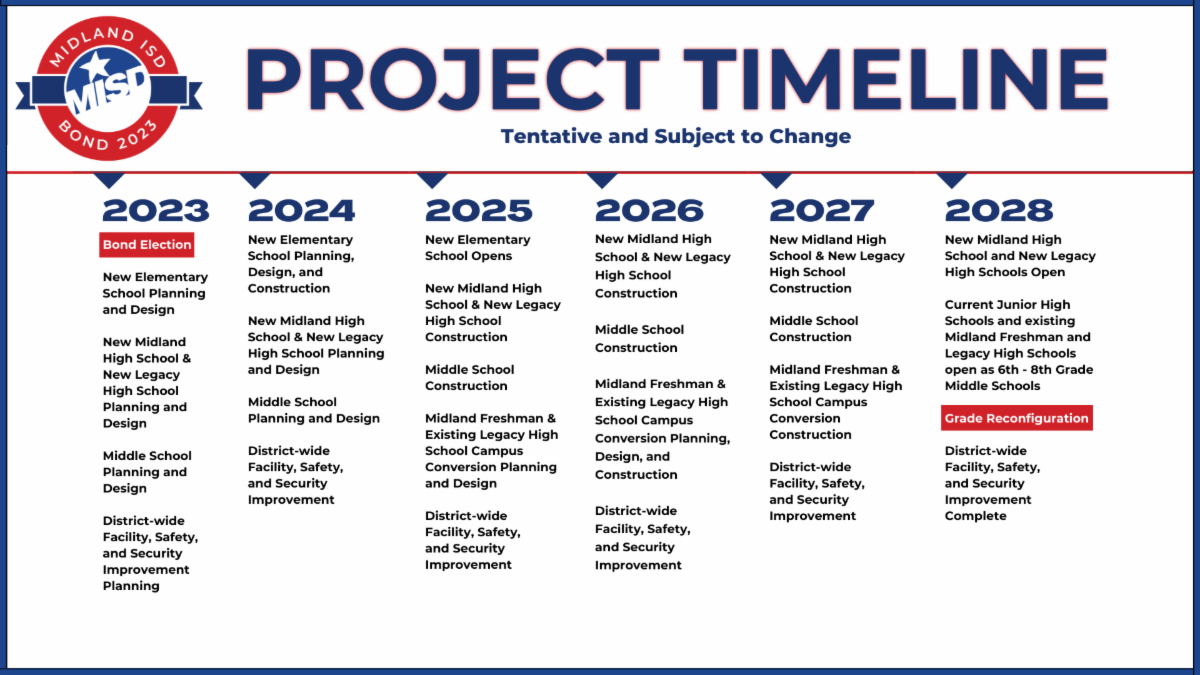

The new elementary school is on schedule to open in the Fall of 2025 with the groundbreaking scheduled for June 6th of this year. Since this school is a prototype of the current Fasken and Yarbrough elementaries, district leaders and architects have worked closely with current tenants of the campuses, including principals, nurses, and special education departments, to make adjustments to the design. The budget for the new elementary school is $53,300,000, and the district is pleased to report that the construction bid came in approximately $8,500,000 under budget.

The committee was presented schematic design views of the high schools, and an overview was given of the layout including academic space placement, traffic flow, parking spaces, fine arts placements, and athletic fields. The designs shown are preliminary and subject to change throughout the design process.

The elementary school “Group A” package was discussed, and includes campuses currently without security vestibules. Construction on these projects is expected to begin in the spring of 2025.

Package 4, Midland Freshman and Goddard Junior High, make up the first middle school package. These campuses have the same floor plans and will be converted to middle schools when grade reconfiguration takes place in 2028.

Alamo Junior High School makes up the Middle School Group B package. Elements of this project include new classrooms, a secured vestibule, a new library, dining expansion and kitchen upgrades, and a new sprinkler system. Construction is expected to begin in the Summer of 2025.

Package 6 includes access control updates, security cameras, and emergency communication enhancements to 23 elementary schools. The community can expect to see construction begin this summer.

Site Improvements to Midland Freshman High School encompasses Package 7. Construction on this project is expected to begin this summer.

The remaining bond packages associated with the 2023 MISD school bond are continuing to be developed.

FINANCE

BOND SALE

The first bond sale related to the voter-approved 2023 bond was discussed to provide insight on the successful pricing.

The district’s bond pricing ranked among the top three deals in the negotiated municipal bond market on March 5th for a total issuance amount of $900 million. There was much interest from investors, which led to a lower-than-planned interest rate.

During the bond planning process in 2023, the district assumed an interest rate on bondsales to be between 5.25% – 5.50%. The district is pleased to report that due to the high interest from investors, the true interest rate came in significantly lower at 4.09%, resulting in approximately $310 million in interest savings when compared to the planning amount.

Historical debt savings from refunding and defeasing outstanding debt dating back to Series 2012 were presented along with a future defeasance scheduled for August of this year. The defeasance will pay off a large majority of the existing principal amount for Series 2015-2020.

FINANCIAL TRANSPARENCY DASHBOARD & WEBPAGE

A dedicated page to MISD Bond 2023 financials has been added to midlandbond2023.com. A pillar of the page includes the financial dashboard, and as been added to provide the community with project spending progress.

COMMUNICATIONS

WEBSITE

The midlandbond2023.com website continues to be used to inform the community of project updates. The website has received major updates in the recent weeks including the dedicated financial page, campus profile updates, and an In the News section.

The Bond Advisory Committee met for the second time to hear a report on the status of the 2023 MISD Bond.

The committee was reminded of their roles and responsibilities and will meet with district leaders quarterly. They will hear reports on construction and project timelines; cost of projects and finance reports; and communication and marketing efforts.

The committee will present to the Bond Planning Committee annually each May and present the final report on Bond 2023 to the Board of Trustees.

OPERATIONS

NEW HIGH SCHOOLS

  • Pfluger Architects has been selected for architectural and engineering services of the two new comprehensive high schools based on their qualifications.
  • Dunaway has been approved by the Board of Trustees as the surveying firm for the two new high school projects.
  • The design phase for the new high schools is currently underway.
  • District and campus leaders visited schools in the Dallas/Ft. Worth area and Lubbock Cooper. These site visits were intended to provide attendees an idea of how 21st century learning spaces look. The visits allowed attendees to provide feedback to architects about areas of these campuses that would be a good fit for the new Midland High School and Legacy High School.
  • Peer group meetings will be held March 5th and 6th to discuss specific areas of design for the new high schools. Pfluger’s architectural team will facilitate these meetings. These meetings are intended to discuss specific areas of the schools with representatives from the district familiar with each area.
  • The completion date of the schools is slated for 2028.
  • The cost to build the new high schools is $985,200,000.

MIDDLE SCHOOL ADDITIONS/CONVERSIONS

  • Programming packages are being developed for the middle schools.
  • At the February board meeting, JSA Architects was approved as the architectural and engineering firm, based on their qualifications, that will provide planning, design and construction administration to Goddard Junior High and Midland Freshman High School. Upon grade reconfiguration in 2028, MFHS will be converted to a middle school. These two campuses exhibit the same floor plan, and, combined, create the largest middle school package. It was a priority to begin work on these projects first.
  • Completion of classroom additions is slated for August 2026.
  • The cost of the middle school additions and conversions is $123,200,000.

NEW ELEMENTARY SCHOOL

  • Parkhill Architects has been selected for the architectural and engineering services of the elementary school based on their qualifications.
  • The new elementary school will be a Parkhill prototype design similar to the current Fasken and Yarbrough elementary campuses. This will save significant costs and design time.
  • Because Parkhill is the Project Manager for the overall Bond project, they will not receive management fees associated with the elementary project.
  • Campus leaders from Fasken Elementary and Yarbrough Elementary have met with Parkhill to provide feedback and suggestions for making improvements to the design of the new campus.
  • The target completion date is scheduled for 2025, and groundbreaking is intended to take place late spring or early summer of this year.
  • The project cost is $53,300,000.

SAFETY AND SECURITY

  • Packages are currently being developed for the design phase of safety and security projects that will take place district-wide.
  • Vandergriff Group Architects, based on their qualifications, was approved by the Board of Trustees as the architectural and engineering firm that will provide planning, design and construction administration at eight elementary schools. This eight school package was given priority as these campuses are currently without security vestibules. The elementary schools in this package include: Bush, De Zavala, General Tommy Franks, Lamar, Parker, Sam Houston, Santa Rita, and Scharbauer elementaries.
  • Targeted completion of all safety and security projects district-wide is August 2028.
  • The cost for all safety and security projects is $50,300,000.

UPGRADES TO AGING FACILITIES

  • Packages are currently being developed for the design phase of the projects.
  • All projects have a target completion date of August 2028.
  • The overall cost for upgrades to aging facilities is $203,400,000.

FINANCE

BOND SALE

At the February meeting of the Board of Trustees, the order authorizing the issuance of Midland ISD Unlimited Tax School Building Bonds at the amount of $900 million was approved. The sizing of the first bond issuance will provide approximately 28-30 months of projected expenditures. The remaining amount of unissued bonds is projected to be issued in 2026; however, this will solely depend on the need.

S&P AND MOODY RATINGS

Moody’s issued MISD an Aa1 rating and improved its outlook to “positive” from “stable.” S&P confirmed its AA rating. This can lead to low interest rates for the upcoming bondsale. These high ratings are great for both bond investors and Midland taxpayers. They show investors that MISD bonds are a low-risk investment. For the taxpayer, these ratings should result in a lower interest rate, saving on total repayment.

FINANCIAL TRANSPARENCY DASHBOARD

A financial dashboard will soon be added to midlandbond2023.com to provide the community with project spending progress.

COMMUNICATIONS

WEBSITE

The midlandbond2023.com website will continue to be used to inform the community of project updates. The website will regularly be updated with project status and financial information along with Bond Advisory Committee meeting recaps. A financial dashboard will be added to the site to keep the transparency of bond spending at the forefront.

BOND ADVISORY COMMUNICATION

An overview of communication that will be sent to the Bond Advisory Committee members was presented. Members of the committee will receive monthly previews of bond items that will be reported and/or voted on during regular monthly school board meetings. Recaps of the quarterly Bond Advisory Committee Meetings will be sent to committeemembers as well as the Midland community at large. In the interim, should any items of note arise, Bond Advisory Committee members will receive notification.

STRATEGIC COMMUNICATION PLAN

The MISD Communications Department, along with Parkhill and Pfluger, have been working together to create a strategic communications plan that aligns communication and project planning, design, and construction phases.

SIGNAGE

Signs have been placed at the sites of the new elementary school in Lone Star Trails and the locations of the new MHS and LHS.

Campus packages are being developed, and signs will be placed in front of campuses once those have been finalized.

The Bond Advisory Committee met for the first time to hear a report on the status of the 2023 MISD Bond that passed in November.

The committee was introduced to their roles and responsibilities and will meet with district leaders quarterly. They will hear reports on construction and project timelines; cost of projects and finance reports; and communication and marketing efforts.

The committee will present to the Bond Planning Committee annually each May and present the final report on Bond 2023 to the Board of Trustees.

OPERATIONS

NEW HIGH SCHOOLS

  • An overview of the programming, design, and construction phases of the new high schools was given.
  • The completion date of the schools is slated for 2028.
  • The cost to build the new high schools is $985,200,000.

MIDDLE SCHOOL ADDITIONS/CONVERSIONS

  • An overview of the programming, design, and construction phases of the middle school additions and conversions was given.
  • Completion of classroom additions is slated for August 2026.
  • The cost of the middle school additions and conversions is $123,200,000.

UPGRADES TO AGING FACILITIES

  • Packages are currently being developed for the design phase of the projects.
  • All projects have a target completion date of August 2028.
  • The overall cost for upgrades to aging facilities is $203,400,000.

SAFETY AND SECURITY

  • Packages are currently being developed for the design phase of safety and security projects that will take place district-wide.
  • Targeted completion of all projects is August 2028.
  • The cost for all safety and security projects is $50,300,000.

NEW ELEMENTARY SCHOOL

  • An overview of the design and construction phases of the new elementary school that will be built in the Lone Star Trails subdivision.
  • The target completion date is scheduled for 2025.
  • The project cost is $53,300,000.

PROJECT MANAGER

The committee received an introduction from Parkhill, the Bond Program Manager, and learned about their roles and responsibilities throughout the process including staying on scope, budget, and schedule.

FINANCE

RESOLUTION FOR REIMBURSEMENT

In September, the Board of Trustees passed a resolution that allows the district to reimburse themselves for expenses incurred related to Bond 2023, up to $50 million dollars. This allows the district to begin working on all bond projects without having to wait for bond dollars to be sold and received prior to spending funds.

Without a reimbursement resolution, incurring any cost associated with the bond program prior to selling bonds, the district would be required to spend local funds, which are already subject to recapture, and would result in the district not being reimbursed.

BOND SALE

The district is reviewing the construction timeline and working with our financial advisor to plan future bond sales strategically. Bond sales are expected to begin in the spring/summer of 2024.

RFQ TIME FRAME

An RFQ will be sent on November 30 to create a pool of underwriters for the district to utilize moving forward. The district will recommend the pool of qualified underwriters to the board before the March board meeting.

FINANCIAL PROCESS

The district will work with the Bond Program Manager to ensure projects stay within budget, review all construction invoices for accuracy, and provide financial transparency throughout the duration of the bond program

COMMUNICATIONS

WEBSITE

The midlandbond2023.com website will continue to be used to inform the community of project updates. The website will regularly be updated with project status and financial information along with Bond Advisory Committee meeting recaps.

COMMUNITY ENGAGEMENT

Ideas were discussed surrounding community engagement including the creation of regularly produced project update videos and ground breakings.
